Watch Our Latest Project Update!
An update from the team on what’s been happening and what’s in store for the future at Smiths Lane.
Follow the progress of your Smiths Lane land below as we prepare it for your dream home.

| Stage | Lots | Development Phase | Estimated Titles Date | Status |
|---|---|---|---|---|
| Stage 33 | 3301 - 3350 | Titled | October 2026 | Active |
| Stage 34 | 3401 - 3458 | Compliance Testing | November 2026 | Active |
| Stage 45B | 4501 - 4526 | Road Paving & Concreting | Jan - Feb 2027 | Active |
| Stage 46 | 4601 - 4655 | Sewer & Drainage | May - June 2027 | Active |
| Stage 47A | 4701 - 4713 | Road Paving & Concreting | Jan - Feb 2027 | Active |
| Stage 47B | 4714 - 4729 | Sewer & Drainage | April - May 2027 | Active |
Discover the Journey Behind Your Future Home
At Smiths Lane, every stage of construction is guided by thoughtful planning, expert craftsmanship and a vision to create a place families are proud to call home. Explore the steps below to see how the land construction process unfolds and what's happening next at Smiths Lane.
-

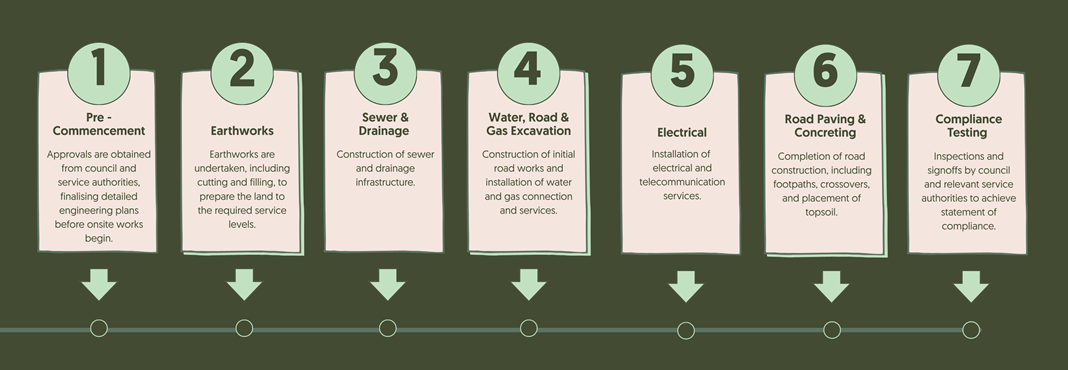

Stage 1: Pre - Commencement
Approvals are obtained from council and service authorities, finalising detailed engineering plans before onsite works begin.
-
Stage 2: Earthworks
Earthworks are undertaken, including cutting and filling, to prepare the land to the required service levels.
-
Stage 3: Sewer & Drainage
Construction of sewer and drainage infrastructure.
-
Stage 4: Water, Road & Gas Excavation
Construction of initial road works and installation of water and gas connection and services.
-
Stage 5: Electrical
Installation of electrical and telecommunication services.
-
Stage 6: Road Paving & Concreting
Completion of road construction, including footpaths, crossovers, and placement of topsoil.
-
Stage 7: Compliance Testing
Inspections and signoffs by council and relevant service authorities to achieve statement of compliance.
